Adaptable Group constructs, follows and delivers on carefully calculated programs.

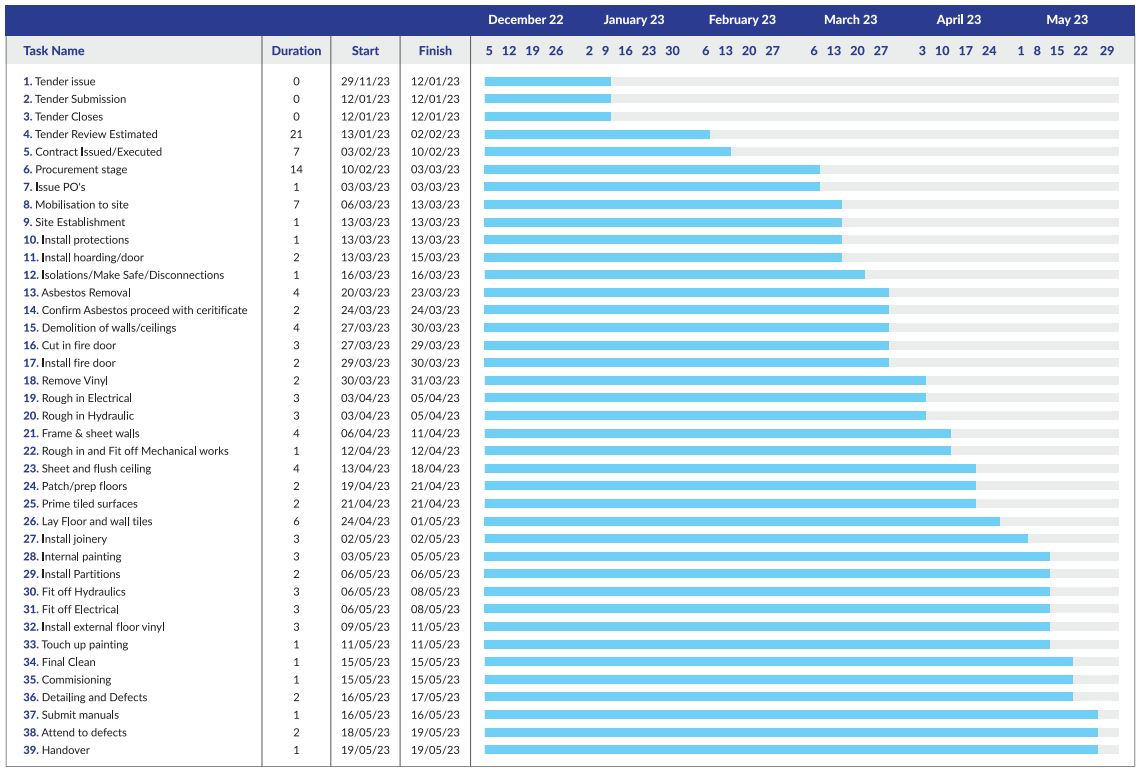

The Gantt Chart below outlines proposed methodology and construction program, for example.
CONSTRUCTION PROGRAM REV A 11/01/22 - ADAPTABLE GROUP
- Meet with HSS
- Arrange all loose furniture, HSS items to be removed
- Notify suppliers and issue Gantt chart
- Obtain inductions, SWMS, Data sheets and JSAs and compile site specific file
- Have final measure for any custom lead time products
- Arrange Bin Delivery, Surface protections, Hoarding and exclusion zones
- Electrical and fire isolations
- Strip out Light weight walls and other demo
- Asbestos Removal
- Build light weight walls where req
- Electrical prelim Works
- Fit new doors
- Painting
- Electrical Fit off
- Carpet/Vinyl
- HSS Furniture Install
- Paint touch up
- Final Clean
- Remove hoarding
- PC
- Defect list
- Handover to client
